Sutter Hospital Medical Center

NOTICE OF PREPARATION (NOP) FOR ENVIRONMENTAL IMPACT REPORT (EIR)(PDF, 7MB)

In March 2026 the City received a revised preliminary application from Sutter Health for an amendment to the Chiron Planned Unit Development to construct a new 330 foot tall, 785,000 square foot hospital (Building B8); a new 50 foot tall, 55,600 square foot building that will either be a medical office building or a 57-unit residential building (Building B1); and to convert two existing buildings to medical office uses (Building B4 and Building B2/3) totaling 563,200 square feet. The site address is 5300 Chiron Way.

In August 2026, as a result of community, Committee, Commission and Council feedback, the applicant revised the application so as to convert the PDU site to into a new 25,850 square foot park; relocate the shuttle depot at the Hollis Green and increase the housing variant on Building B1 site from a 57-unit workforce residential building to a 133-unit residential building. In addition, the project also proposes to construct raised bicycle lanes on Horton Street between 53rd Street and 62nd Street, thereby creating a continuous protected bicycle facility in both directions along Horton Street from 45th Street to 62nd Street. The remaining project components will remain the same.

Site Plan - Proposed Emeryville Medical Center Project Site and Buildings

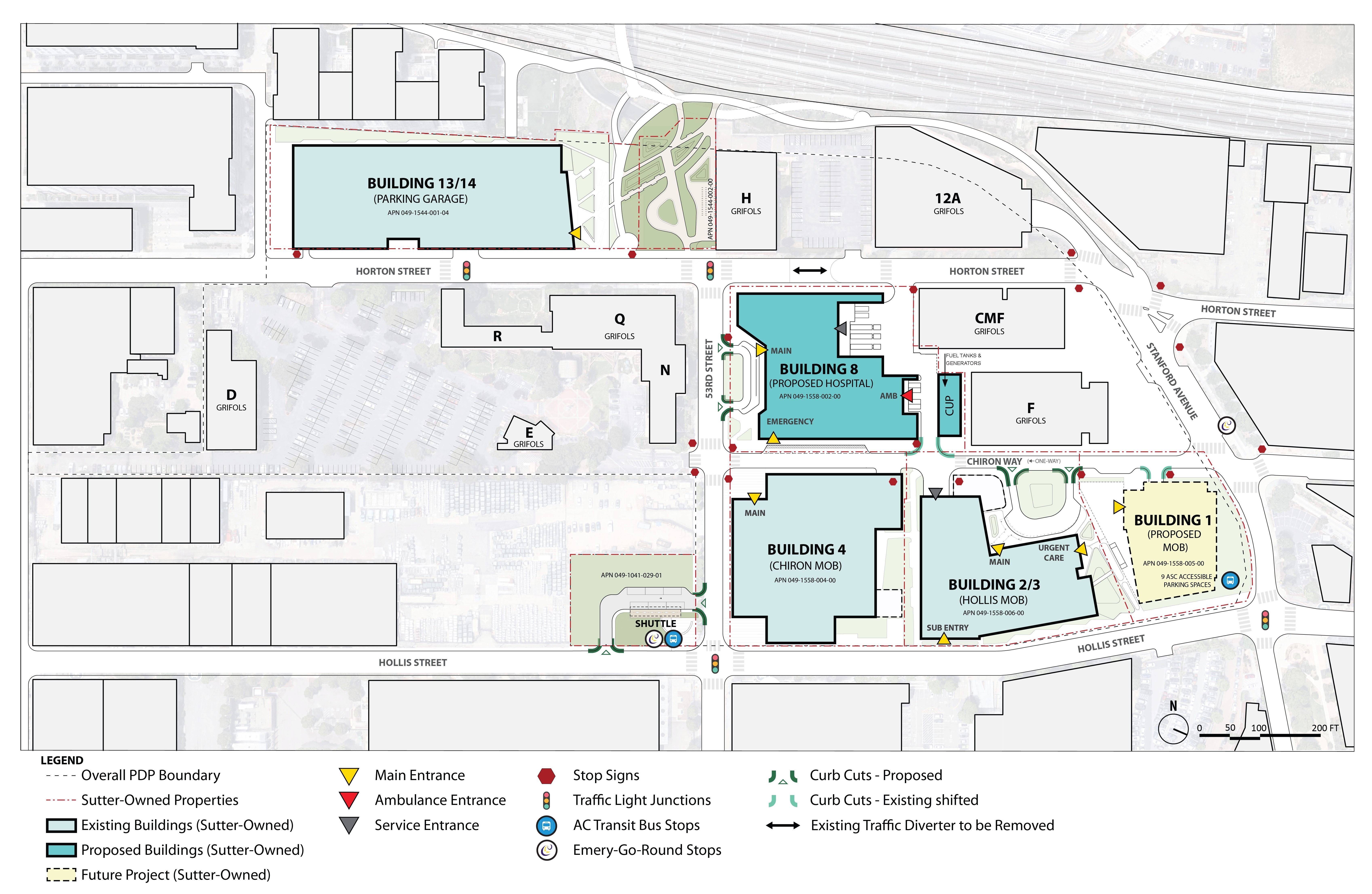

Sutter Site Plan Graphic for Website.jpg



The City has hired Urban Planning Partners (UPP) to conduct analysis required by the California Environmental Quality Act (CEQA) for the project.

Below is the schedule of meetings that will be conducted as part of the City's review process:

Meeting Date & Time Location
Sutter Health Community Meeting
Flyer(PDF, 445KB)
May 18, 6:00 PM 5300 Chiron Way,
2nd Floor
Bicycle/Pedestrian Advisory Committee June 1, 5:30 PM Civic Center
1333 Park Ave,
Garden Level
Commission on Aging June 10, 10:00 AM Senior Center
4321 Salem St
Parks and Recreation Committee June 17, 6:00 PM ECCL
4727 San Pablo Ave,
Building B
Planning Commission – Study Session
Staff Report(PDF, 318KB)
Memo to Planning Commission(PDF, 2MB)
Public Comments(PDF, 10MB)
Applicant Presentation(PDF, 23MB)
Staff Presentation(PDF, 6MB)
Video
June 25, 6:30 PM Civic Center
1333 Park Ave
Council Chambers
City Council – Study Session
Staff Report
Public Comments(PDF, 2MB)
Applicant Presentation(PDF, 13MB)
Staff Presentation(PPTX, 12MB)
Video
July 21, 6:00 PM
Planning Commission – EIR Scoping Session
Staff Report(PDF, 116MB)
Public Comments(PDF, 51MB)
Video
August 27, 6:30 PM
Planning Commission - Study Session II TBD
City Council - Study Session II   TBD

FAQs

1. Is Sutter Hospital Medical Center a City-sponsored project?

No. This is a private development proposal, and it will require permits from the City.

2. What permits are required before this project can begin construction?

It will require Planning permits or entitlements from the City. Specifically, the Planning permits that will be required include a Planned Unit Development (PUD) permit; a General Plan Amendment; a Final Development permit; and a Tree Removal permit. Before the City can issue these permits, an Environmental Impact Report (EIR) will be prepared by the City in accordance with the California Environmental Quality Act (CEQA).

3. What is Planned Unit Development (PUD)?

The City’s PUD procedure allows for the creation of a PUD zone to encourage the creative development of large sites and to allow flexibility in development and design standards. It is effectively the zoning for the site, where development can either occur all at once or be phased over a specified timeframe.

4. Why does this project require a PUD Amendment and not a new PUD permit?

On this site, a PUD permit was originally approved for the Chiron Corporation in August 1995. In 2006, Chiron was acquired by the Swiss pharmaceutical firm Novartis. In November 2013, the diagnostics unit of Novartis was sold to Grifols, a multinational pharmaceutical and chemical manufacturer based in Barcelona, Spain. The remaining Novartis portion of the PUD was acquired by Biomed Realty (“BMR”) in March 2019. In February 2021, the Planning Commission approved a Final Development Plan (FDP) permit to build a parking structure and four new “Research and Development” (R&D) buildings. BMR constructed the parking structure and one new R&D shell building in 2022-23. The site is currently entitled for “Research and Development” uses and not for hospital and ambulatory medical office uses. Sutter therefore needs to obtain an amendment to the existing PUD permit from the City, to allow for these uses.

5. What is the development review process for PUDs?

The flow chart below outlines City’s development review process. We are currently on Step 13 of the flow chart.

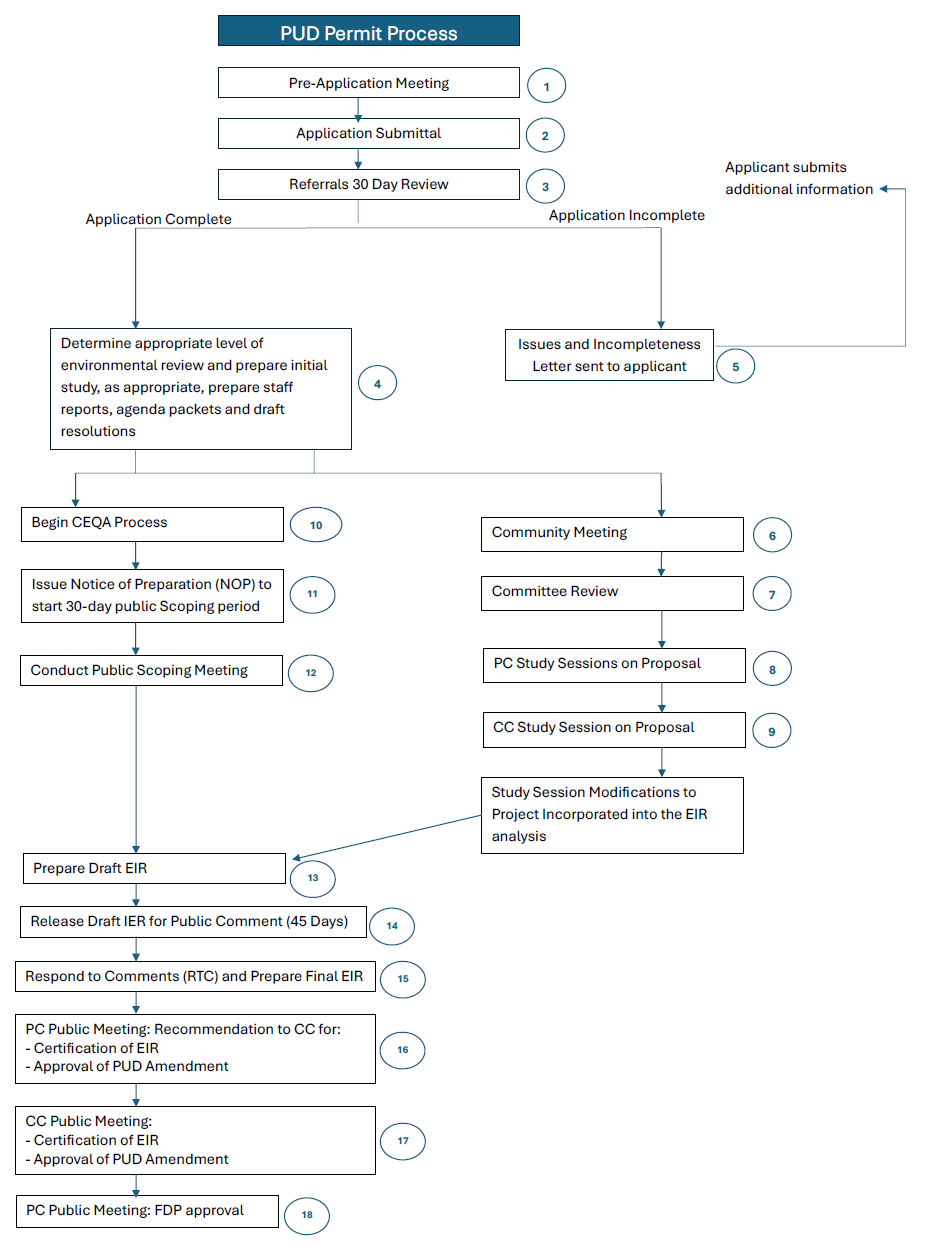

PUD Flow Chart.png



6. What is an Environmental Impact Report (EIR)?

An EIR is a document that looks at how a proposed project could affect the environment, what could be done to reduce or avoid those impacts, and what alternatives to the project might be possible. An EIR typically looks at issues such as traffic, air quality, noise, water, biological resources, historic resources, greenhouse gas emissions, and impacts on people and communities.

7. Why is an EIR prepared?

The purpose is to help government decision-makers (Planning Commissioners and City Council members) and the public understand the potential environmental consequences of a project before the project is approved.

An EIR generally answers four basic questions:

  1. What is being proposed?
  2. How could the project affect the environment?
  3. Can those impacts be avoided or reduced?
  4. Are there reasonable alternatives that would cause fewer environmental impacts?

8. Who prepares an EIR for a project?

The City prepares an EIR for a project, in compliance with the State law (California Environmental Quality Act or CEQA). An EIR is a comprehensive environmental study prepared under CEQA that identifies a project's potential environmental impacts, evaluates ways to reduce those impacts, and considers alternatives before a public agency decides whether to approve the project.

The City of Emeryville has hired Urban Planning Partners (UPP) to prepare EIR for the Sutter Hospital Medical Center.

9. Who pays for the EIR?

The project sponsor, Sutter Health, has deposited the full amount of UPP’s contract to prepare EIR for the project, with the City. The City manages, directs and pays UPP directly through the deposit submitted by Sutter with the City.

10. When is the Draft EIR (DEIR) expected to be released for public comment?

Currently, it is anticipated that the DEIR for 45-day public comment period will be released in early Spring 2027.

11. How will members of the public access the DEIR?

The document will be posted on this website. Three hard copies will be made available for public for in-person review at City Hall. Due to the anticipated length of the document, hard copies will not be made available. An electronic copy will be mailed to those who make a request.

12. What are the key project characteristics of the proposed Sutter Hospital Medical Center?

Below is a project summary provided by the applicant and included in the July 21st, 2026 City Council Study Session staff report.

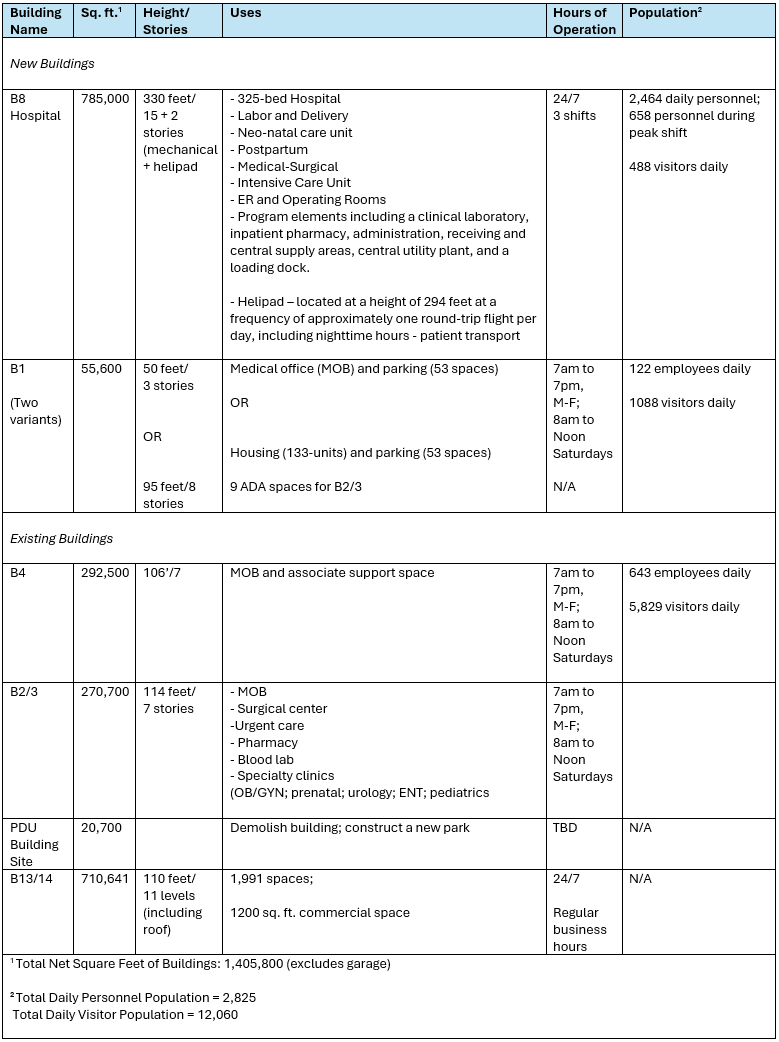

Sutter Key Project Characteristics.png



13. What this the construction schedule for the Sutter Hospital Medical Center?

Below is the current estimated construction schedule provided by the applicant.

Sutter Construction Schedule.png



14. How can I get on the mailing list for this project?

You can be put on the list by emailing to the project manager, Miroo Desai, at mdesai@emeryville.org.

For further information please contact project manager Miroo Desai at mdesai@emeryville.org.
